CULTIVA GROWROOM · MALTA · 2026

Same price.
Completely different facility.

VENDOR OFFER
€0
incomplete bid + €24 500 hidden scope (shipping, install labour, missing items)
VS
MAX GOZO TURNKEY
€0
fully engineered, 5 week build, solar included
Engineered by Max Gozo · Delivered installed and commissioned for €82 855
scroll ↓
EXECUTIVE SUMMARY

The opportunity in one paragraph

Max Gozo offers a fully-engineered commercial cannabis cultivation facility on the island of Malta for €82 855 turnkey — essentially identical in headline price to the previously presented vendor offer (€82 584), but built around a correctly-sized cooling system, named-brand premium horticultural lighting with verified efficiency, a fully-local automation control plane with no cloud dependencies, a 15 kWp solar generation system that pays back in under 3 years, and the full Maltese cannabis licensing compliance scope. The vendor's offer is missing approximately €24 500 of critical scope (including shipping from Poland to Malta and the installation labour itself, both of which the vendor did not include); once that's added, the realistic vendor cost is €107 108 — making the Max Gozo turnkey €24 253 cheaper than the realistic vendor cost while delivering a facility that survives the first Maltese summer.

VISUAL

The two facilities, side by side

Same price, completely different facility
FACILITY OVERVIEW

The Cultiva facility — engineered to scale

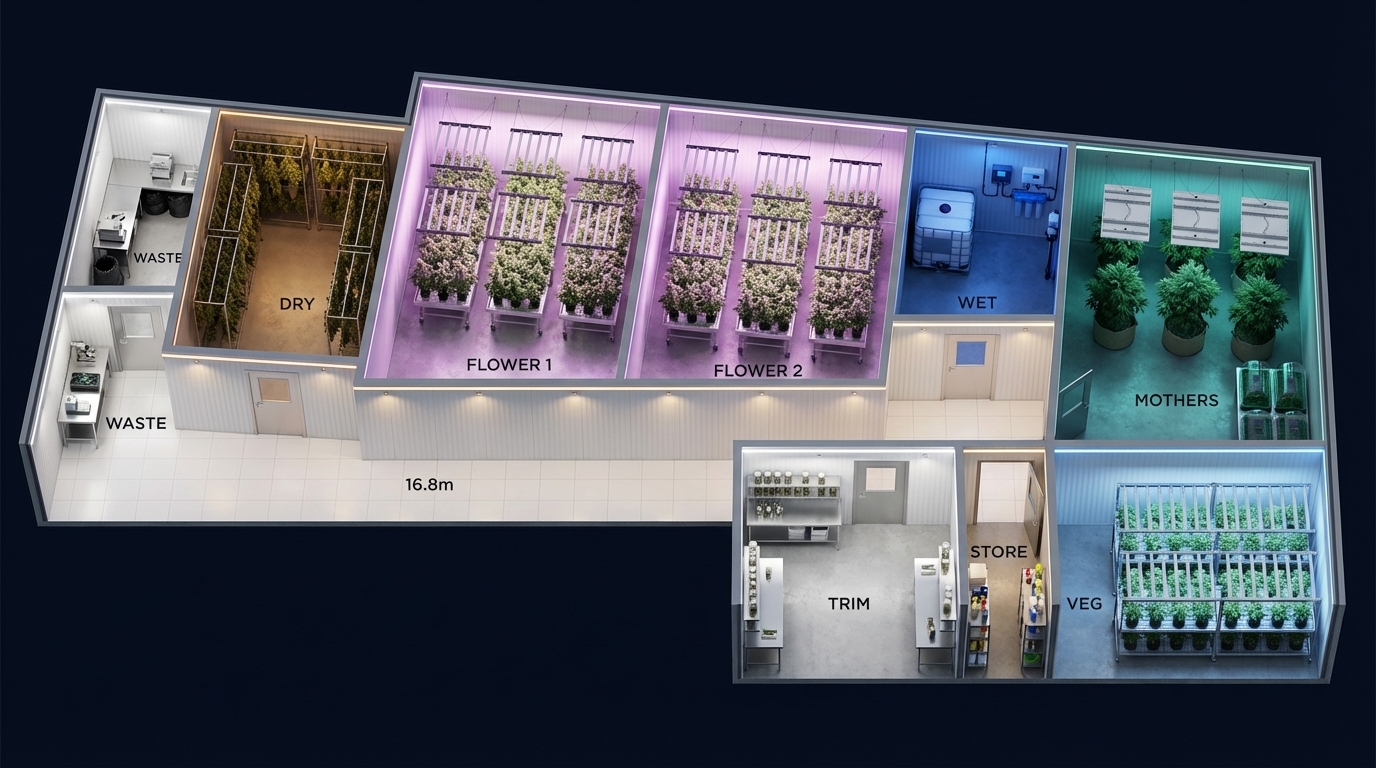

Isometric architectural rendering of the Cultiva medical cannabis cultivation facility on the island of Malta — 10 rooms, 32.4 m² flowering canopy, 15 kWp rooftop solar, 5-week build

A long rectangular medical cannabis cultivation facility on the island of Malta, ~170 m² total footprint, organised into 10 functional rooms plus a central corridor: waste processing, drying, two flowering rooms (26.7 m² each), wet room / irrigation, mothers & cloning, trim, store, and vegetative. Rooftop carries the locked 15 kWp solar PV array + 15 kWh battery alongside the inverter air-conditioning condensers and the propane CO₂ generator exhaust. Total flowering canopy: 32.4 m². Target dry yield: ~78 kg/year at four cycles per year, perpetual harvest.

VENDOR ANALYSIS

Why the previously presented vendor offer should be rejected

01

The cooling system is sized for ~50% of the actual heat load

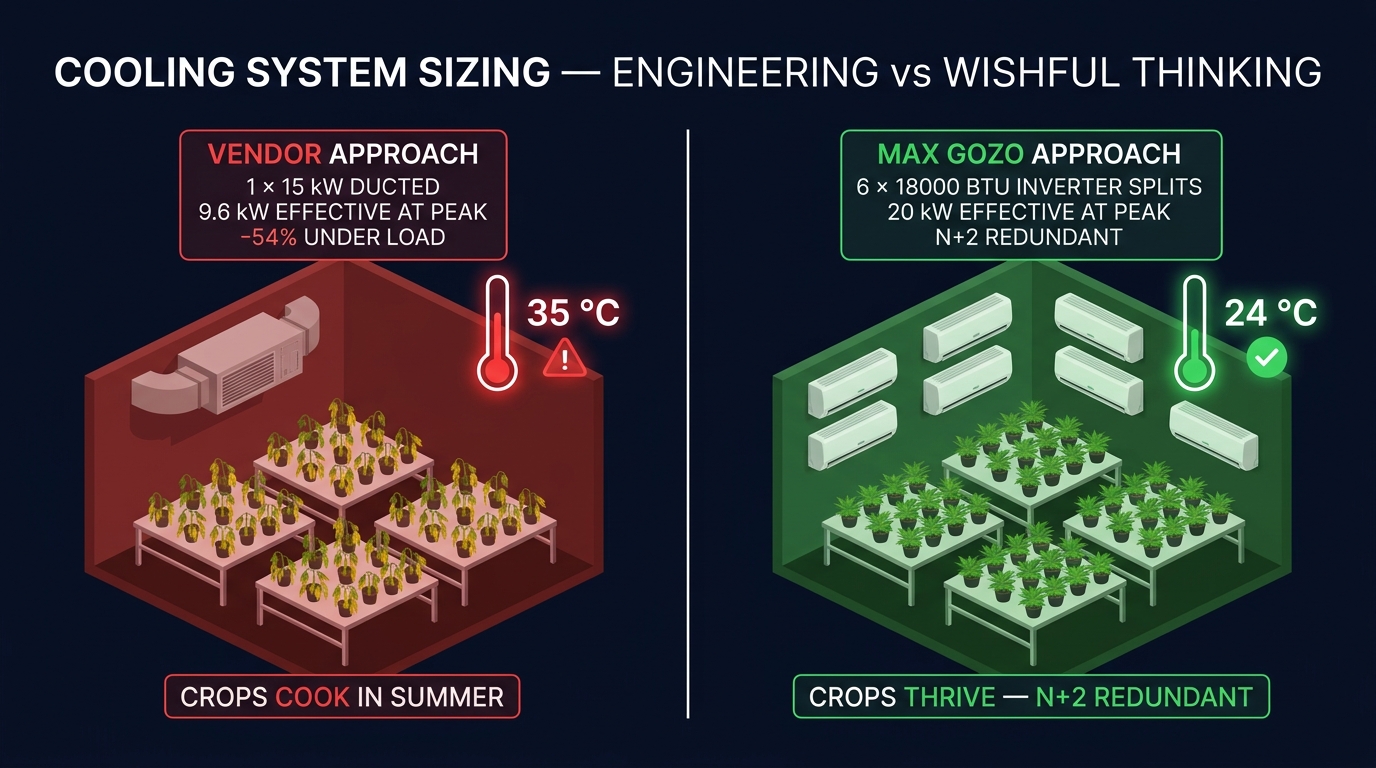

HVAC sizing comparison — vendor 9.6 kW effective vs Max Gozo 20 kW correctly sized

One ducted 15 kW unit per flowering room. After Maltese 38 °C summer derating + Sensible Heat Ratio penalty, effective sensible cooling is approximately 9.6 kW per room. The actual heat load — calculated bottom-up from lighting + dehumidifier reject heat + motors — is approximately 21 kW per flowering room. In any sustained Maltese summer week, the rooms run at 30–35 °C canopy temperature. Terpenes volatilise, transpiration collapses, crops crash.

9.6 kWvendor effective
21 kWactual demand
−54%undersized
02

Premium pricing for anonymous lighting components

The vendor charges €399 per 800 W flowering top fixture. At that price the boards cannot contain genuine premium-grade chips — the diode bill of materials alone for honest premium chips would exceed €450 per board. The offer doesn't name the chip, doesn't disclose the photosynthetic efficiency rating, doesn't include a spectrum graph, and doesn't reference a warranty term.

03

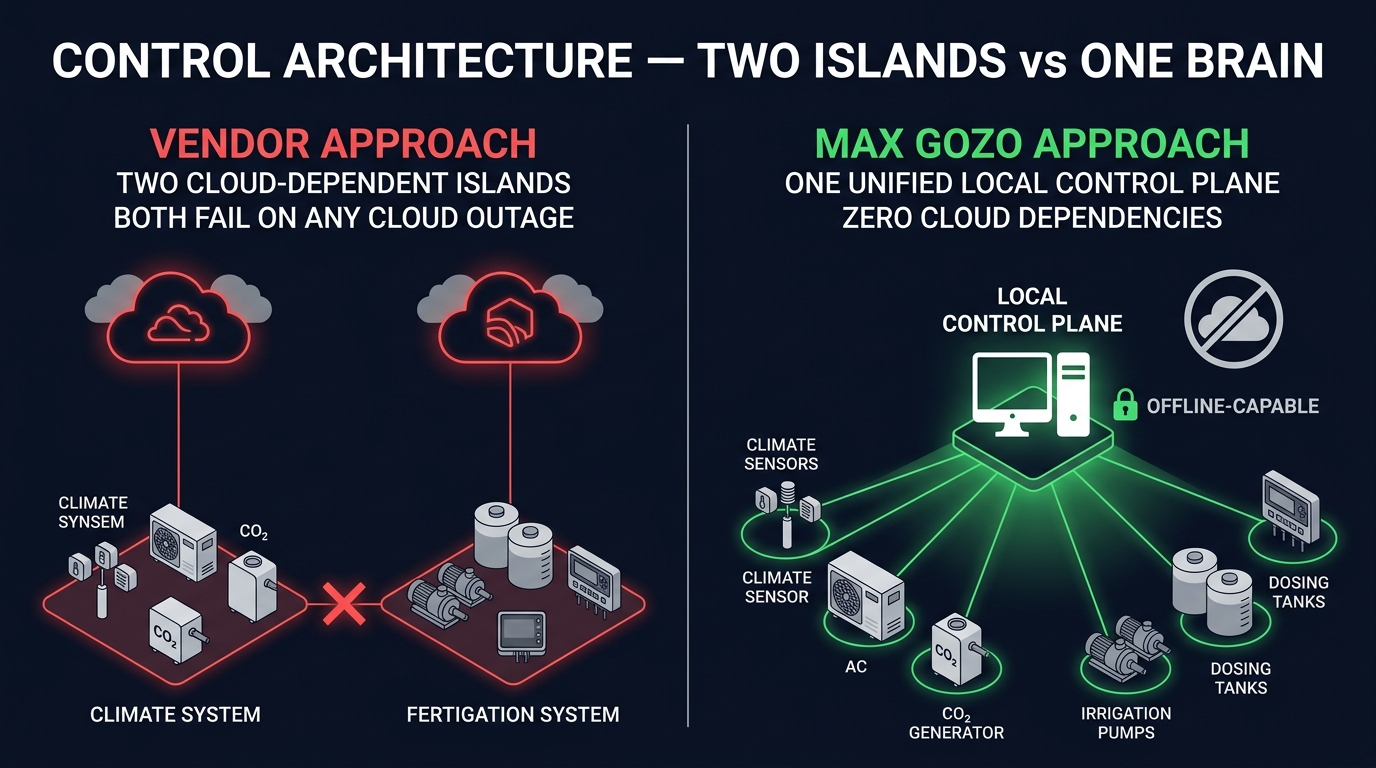

Two cloud-dependent control systems with no integration

Control architecture comparison — two cloud islands vs one unified local control plane

The vendor bundles €11 346 of one cloud-dependent climate system plus €4 989 of a separate cloud-dependent fertigation controller. The two systems do not integrate. Each depends on its respective vendor's cloud infrastructure for alerting, logging, and remote monitoring. Either vendor's solvency is a single point of failure for half the facility's automation. Industry precedent has multiple examples of small commercial automation vendors discontinuing cloud services and bricking customer hardware.

04

Approximately €24 500 of critical scope is missing entirely

Carbon filtration, CO₂ enrichment hardware, backup power, security cameras, mechanical installation, drip lines, tank thermal management, downstream water-quality verification — plus shipping from Poland to Malta and the installation labour itself. The vendor's offer was equipment-only: shipping was not included, and the only "installation" line on the bid was €0. The customer would have had to arrange and pay for freight, F-gas certified HVAC installer, electrician, lighting hanging, and all on-site assembly separately within month one.

CARBON FILTRATION €2 500
CO₂ HARDWARE €1 500
BACKUP POWER €3 000
SECURITY €2 500
MECHANICAL €1 000
DRIP LINES €700
TANK THERMAL €300
EC VERIFICATION €500
SHIPPING PL → MALTA €2 500
INSTALL LABOUR (F-gas + electrician + assembly) €10 000
TOTAL HIDDEN €24 500
WHAT WE DELIVER

Six engineered subsystems

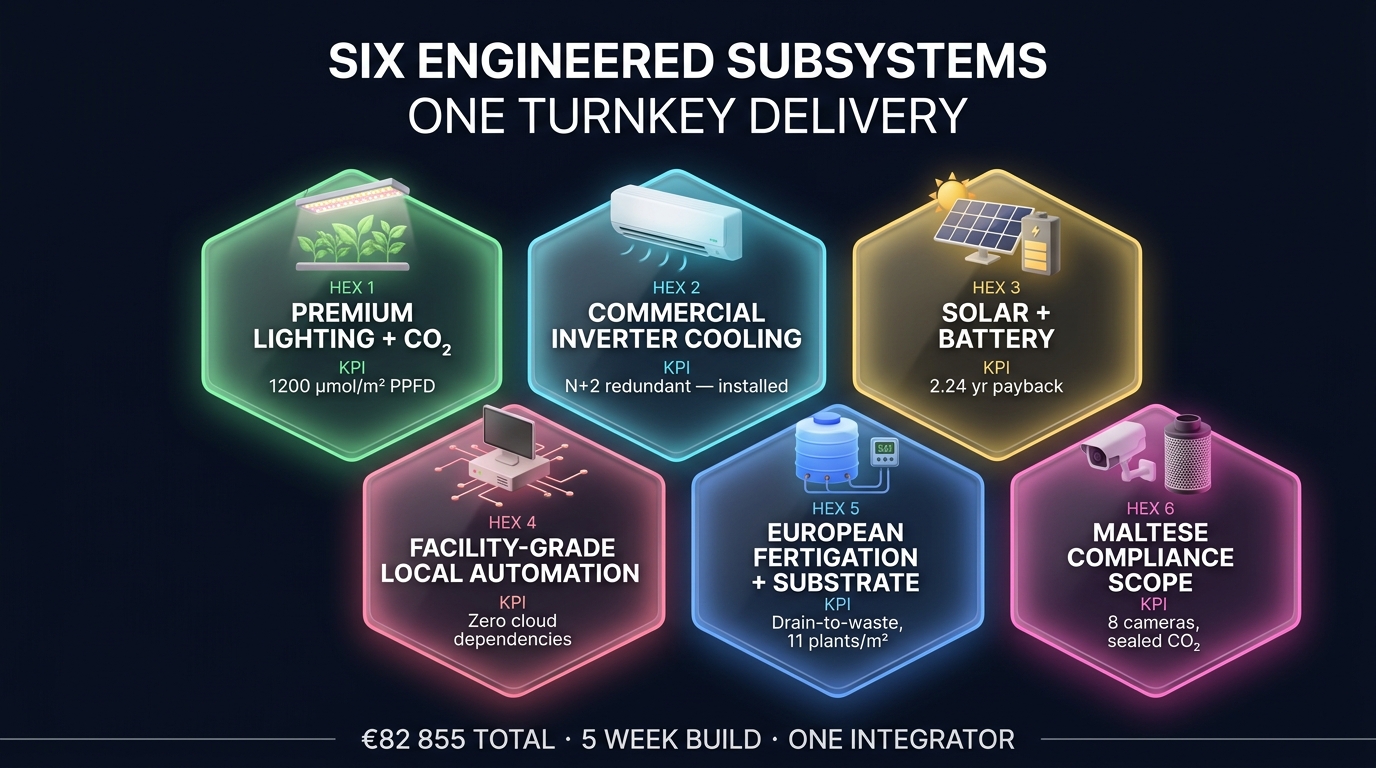

Six engineered subsystems hexagonal overview
01

Premium horticultural lighting + CO₂

24 × 800 W flowering top fixtures with named-brand premium diodes and on-board UV-A. 36 × 120 W intercanopy bars. 36 × dual-purpose veg/clone bars. Horticultural-grade propane CO₂ generation with three independent worker-safety layers.

02

Professional commercial inverter cooling

18 × commercial inverter wall splits installed by F-gas certified Maltese contractor. Sized for the actual 20 kW heat load with 9 % headroom. No single point of failure — any unit can be swapped same-day from Ventura local stock.

03

Facility-grade local automation

Unified local control plane on dedicated facility hardware with UPS, NVMe storage, fully offline-capable. No cloud dependencies anywhere in the climate, sensor, irrigation, or security subsystems.

04

European fertigation + premium substrate

European-sourced commercial fertigation controller. 1 m³ industrial reservoir with continuous oxygenation + ozone sterilisation. Premium European mineral wool substrate. Drain-to-waste cultivation in Dutch tomato-style commercial layout.

05

Solar generation

15 kWp PV + 15 kWh LiFePO₄ battery + 15 kW hybrid inverter. Self-installed and integrated with the facility automation. Pays back in under 3 years.

06

Maltese compliance scope

8-camera 4K PoE security with NVR. Electric strike door locks. Sealed-CO₂-aware low-CFM bleed carbon scrubbing. Professional electrical control cabinet with licensed Maltese electrician sign-off.

INVESTMENT BREAKDOWN

Where the €82 855 goes

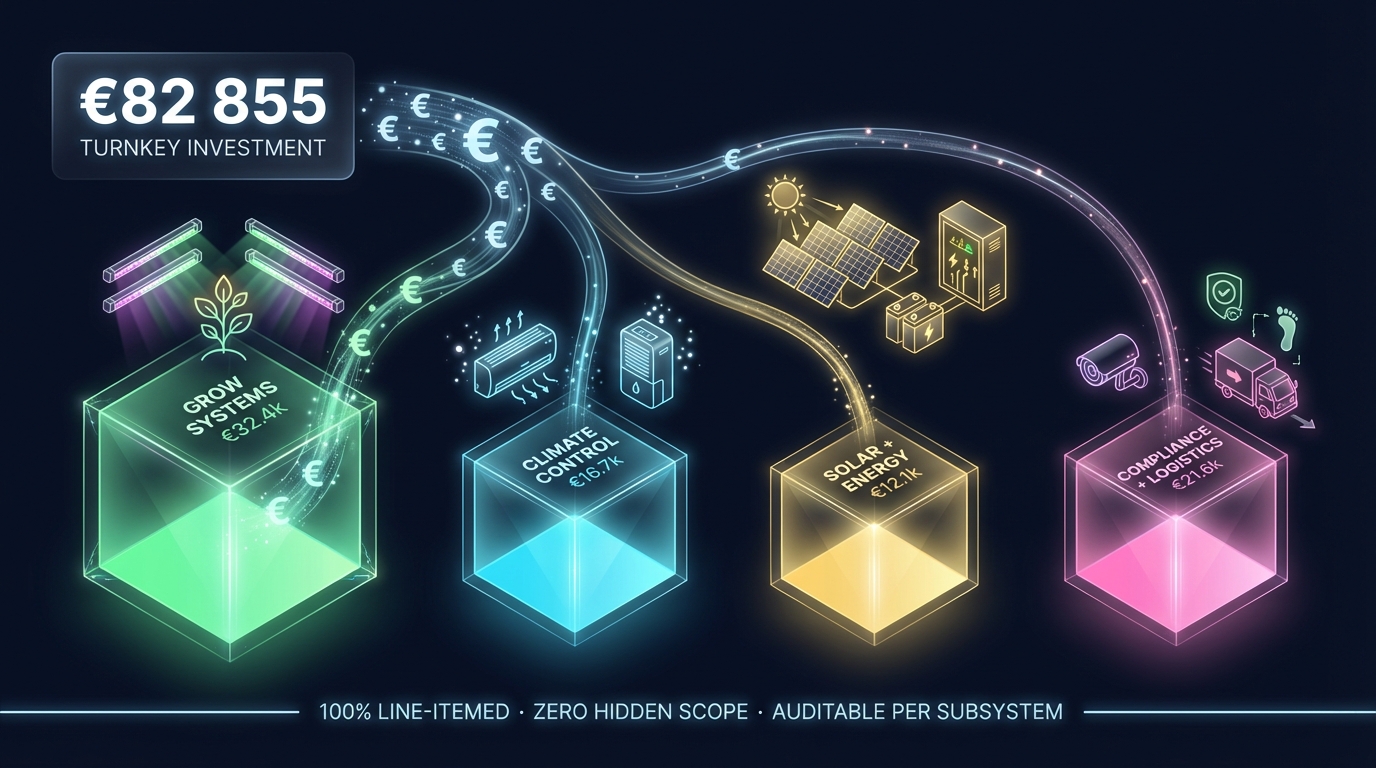

Investment breakdown — €82 855 turnkey flowing into 4 functional buckets

Every line in the investment is mapped to a specific functional subsystem and a specific deliverable. Nothing is hidden inside an "extras" or "miscellaneous" line. The largest single line is the lighting + CO₂ subsystem at 19.8 % of total capex; the smallest is air circulation at less than 1 %. Logistics and installation labour are line-itemed separately so the investor can audit them.

SUBSYSTEM€%
01 · Lighting + CO₂ enrichment16 44119.8 %
02 · HVAC (Hyundai inverter splits, supplied + installed by Ventura Malta)10 48512.7 %
03 · Solar PV + Battery (15 kWp + 15 kWh)9 35011.3 %
04 · Dehumidification (compressor, commercial)7 8769.5 %
05 · Tables & drainage (rolling benches)7 6459.2 %
06 · Automation (Home Assistant + Sonoff + Tasmota local control)4 7895.8 %
07 · Irrigation + water + substrate (Nido Pro + Plagron + Grodan)4 7895.8 %
08 · Electrical cabinet + Maltese sign-off3 9604.8 %
09 · Carbon filtration + security + access control3 9364.7 %
10 · Humidification8801.1 %
11 · Air circulation (canopy + under-table fans)7040.85 %
HARDWARE SUBTOTAL (delivered)70 85585.5 %
12 · Logistics (consolidated freight to Malta)2 0002.4 %
13 · Installation + commissioning + Maltese sign-off10 00012.1 %
TOTAL TURNKEY82 855100 %
TECHNICAL SPECIFICATIONS

Engineering meat — what's actually inside

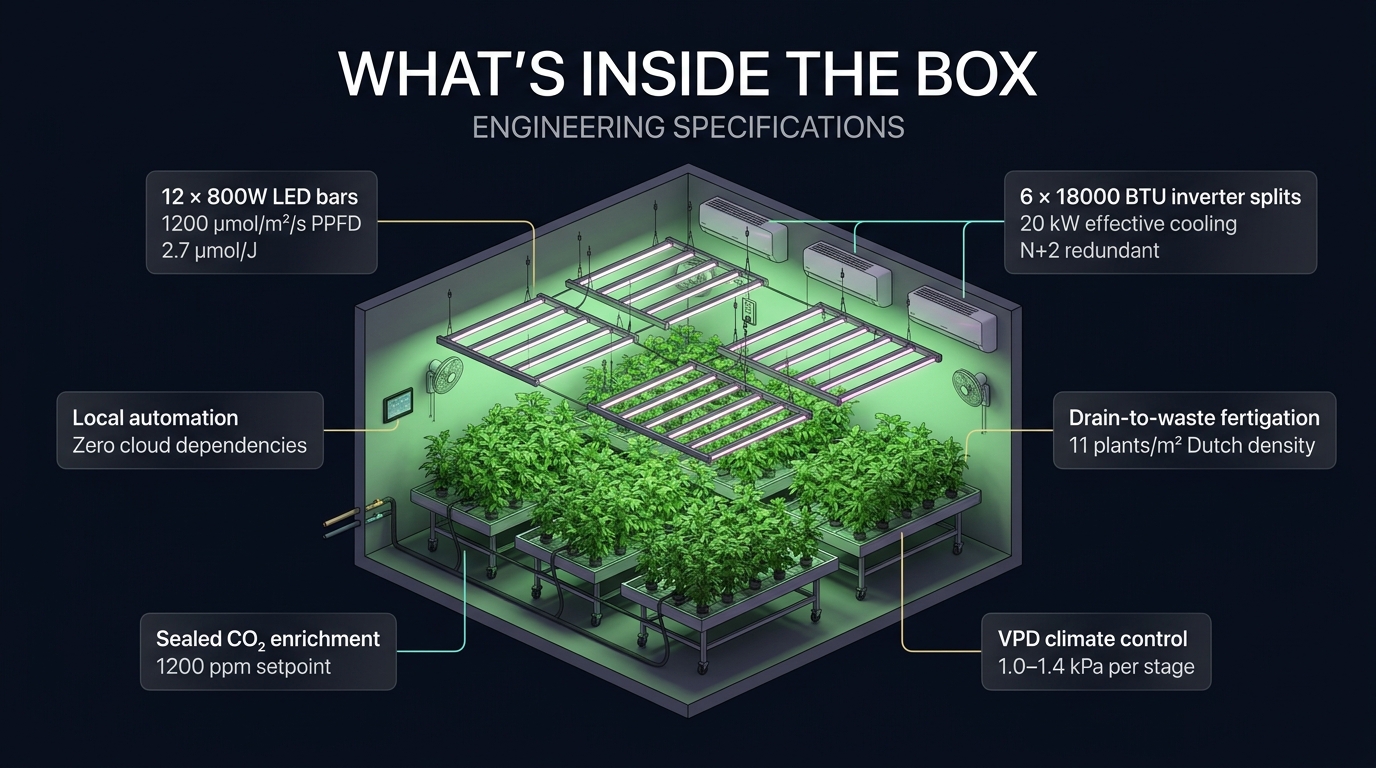

Technical specifications hero — exploded 3D cutaway of a flowering room with all equipment labelled

The supplier identities and exact procurement prices are protected under the single-source delivery model, but the engineering specifications are shared in full here. Every number below is bottom-up from the locked bill of materials and verified against the live Maltese supply chain.

01 · LIGHTING + CO₂

Samsung LM301H + Meanwell HLG · 1 200 µmol/m²/s canopy PPFD · ~25 kW total lighting load

Diode chipSamsung LM301H horticultural-grade quantum board class, paired with Osram 660 nm deep red
DriverMeanwell HLG-600H premium constant-current LED driver, fully dimmable 0–10 V
Flowering top fixtures24 × 800 W bars (~2 100 µmol/s PPF each)
Wall-plug efficacy~2.7 µmol/J (independently verified)
Spectrum3 500 K white + Osram 660 nm deep red + on-board 395 nm UV-A
Intercanopy bars36 × 120 W IP65, dimmable, 660 nm enriched
Vegetative + clone bars36 × 65 W (consolidated identical SKU for spares)
UV safety8 × UV-A protective goggles + door interlock automation
CO₂ enrichment2 × horticultural propane burners, modular 2/6/10 burner heads, ~200 kg propane/yr
CO₂ controlNDIR sensors per room, hardware combustion alarm, automation door interlock
Target room CO₂900–1 200 ppm during light-on, ambient at lights-off
02 · HVAC

Hyundai DC inverter splits · supplied + installed by Ventura Malta · no single point of failure

Supplier + installerVentura Malta — established Maltese white-goods + HVAC distributor with F-gas certified install team. Same-day swap stock for any unit failure. Single point of contact for 18-unit order + commissioning + Maltese warranty support.
Flowering rooms2 × 6 = 12 × Hyundai 18 000 BTU DC inverter splits (5.27 kW nameplate each)
Other rooms (veg / mothers / dry / wet / corridor / store)6 × Hyundai 12 000 BTU DC inverter splits (3.5 kW each)
RefrigerantR32 (low-GWP, current EU standard)
Compressor typeDC inverter, GMCC/Toshiba commercial-grade
Effective cooling per flowering room (peak ambient)~20 kW sensible (sized for 21 kW load with margin)
Redundancy postureNo single point of failure — any unit swapped same-day from Ventura local stock. 6 units provide 9 % headroom over the 20 kW heat load.
InstallationMaltese F-gas certified contractor (Ventura's in-house team), 4 m copper line set per unit included
WiFi controlTuya-class smart kit per unit, integrated into facility automation via LocalTuya
03 · SOLAR

15 kWp PV + 15 kWh LiFePO₄ battery · 27 MWh/yr production · ~2.8-year payback

PV array~38 × 400 W panels, monocrystalline, EU wholesale
Total nameplate15 kWp
Annual production at Malta insolation~27 MWh/yr (1 800 kWh/kWp/yr)
Battery15 kWh LiFePO₄ rack-mount, 6 000+ cycle life rating
Hybrid inverter15 kW, three-phase, grid-tie + island mode capable
Self-consumption rate~70 % during light-on hours + battery cycling
Year-1 grid offset value~€3 800 (24.4 MWh useful × Enemalta band rate)
Grid ride-throughBattery handles routine summer outages; lighting contactor cuts gracefully on extended outage
Maltese grant eligibilitySolar PV Grant scheme (worth chasing pre-construction, can drop payback below 2 years)
04 · AUTOMATION

Home Assistant on Raspberry Pi 5 · Sonoff devices flashed with Tasmota · zero cloud dependencies

Control hostRaspberry Pi 5 8 GB + 1 TB NVMe + UPS, dedicated to facility, fully offline-capable
Operating systemHome Assistant OS open-source local automation platform with ~2 500 native integrations
Sensor protocolZigbee 3.0 + WiFi LAN-mode (no cloud accounts)
Power switching20 × Sonoff POW R3 25 A WiFi power meters with ±0.5 % accuracy, flashed with Tasmota open-source firmware
High-current switching8 × Sonoff 4CH Pro R3 dry-contact relay modules driving 8 × Schneider LC1D25 25 A 3-phase contactors (LED bank switching with Ametherm SL32 NTC inrush limiters)
Climate sensors25 × Sonoff SNZB-02P Zigbee T/H sensors (canopy grid + above + below + 4 critical wired probes per flowering room)
VPD control loopHA template sensor median over 4 canopy probes per room, target 1.0–1.4 kPa per growth stage
CO₂ sensors4 × Sensirion SCD41 NDIR ± 40 ppm
Leak detection16 × under-AC water sensors with Telegram alerting
Door safety interlocks2 × flowering room doors → CO₂ burner cutoff
Logging + alertingLocal InfluxDB + Grafana, Pushover/Telegram alerts, SMS via local cellular gateway
05 · IRRIGATION + WATER

Nido Pro fertigation controller · Plagron Hydro A+B · Grodan rockwool drain-to-waste

Fertigation controllerNido Pro (Nido ONE V2) Italian commercial fertigation controller, 4-channel peristaltic dosing, EC + pH closed-loop, 200–3 000 L tank range, 2-year EU warranty, native power-line integration into facility automation
SubstrateGrodan premium horticultural mineral wool slabs (Grotop Master class), 180 per cycle + 360 Delta propagation cubes
NutrientsPlagron Hydro A+B Dutch 2-part hydroponic base + CalMag + pH up/down + late-flower PK 13/14
Reservoir1 000 L food-grade industrial intermediate bulk container with ultrasonic level sensor
Water treatmentReverse-osmosis at 250 L/h with permeate buffer + UV sterilizer (operator-supplied)
Oxygenation30 L/min commercial air pump + ozone water sterilizer (~10 ppm DO target)
LayoutDrain-to-waste, Dutch tomato-style, 1 slab per 2 plants, ~11 plants/m² density
Manual verificationBluelab Combo Meter professional handheld EC/pH/temp, weekly calibration
Drip linesNetafim PCJ pressure-compensating drippers, 6 zones (one per flowering table)
Tank thermal mgmt1 kW titanium immersion heater + aquarium-grade chiller for Malta seasonal extremes
06 · COMPLIANCE

4K PoE security + CAN carbon scrubbing · Maltese licensing-grade

Surveillance8 × 4K PoE cameras + 8-channel NVR + 4 TB surveillance HDD (commercial PoE kit)
Camera integrationONVIF protocol → Home Assistant alerts on motion during off-hours
Access controlElectric strike locks + card reader + Sonoff SNZB-04P door sensor logging
Odour control architectureSealed-CO₂-aware low-CFM continuous bleed pattern (~50–100 m³/h per flowering room)
Carbon filters2 × CAN-Lite 100 m³/h flowering + 3 × CAN 425 m³/h other rooms
Make-up airHEPA + pre-carbon intake with motorised damper, automation-controlled bleed rate
Electrical cabinet3 × IP55 DIN steel enclosures, Schneider main isolator + RCD + MCBs, Mean Well 24 V DIN PSU, Maltese licensed electrician sign-off
Three-phase load~50 kW peak, ~233 MWh/yr facility consumption
Worker safety layers (CO₂)3 independent: hardware combustion alarm, door interlock, automation runtime cap
PRODUCTION ECONOMICS

78 kg / year at €868 / kg production cost

32.4 m²
flowering canopy
~384
plants per cycle
4 cycles
per year, perpetual harvest
~78 kg
annual dry yield
€868
production cost / kg
€5–8k
market price / kg
SOLAR ECONOMICS

The highest-IRR line in the build

15 kWp PV + 15 kWh battery + hybrid inverter at €8 500 capex. Self-installed from European wholesale, integrated with the facility automation. Verified against the live Enemalta non-residential 3-phase tariff.

€8 500
Solar capex
€3 800
Year-1 savings
~2.8 yr
Simple payback
+€11 276
5-year cumulative net
+€33 108
10-year cumulative net
390 %
10-year ROI
INVESTMENT TERMS

€82 855 turnkey, 3-tranche payment, 5-week build

40 %
€33 142
at contract signature
Polish bulk-quote deposits, weekly truck consolidation, Maltese installer scheduling
40 %
€33 142
at delivery
Maltese installation work, electrical sign-off, solar commissioning
20 %
€16 571
at commissioning
Max Gozo on-site operational support, 14-day post-commissioning window
BUILD TIMELINE

5 weeks from contract to commercial operation

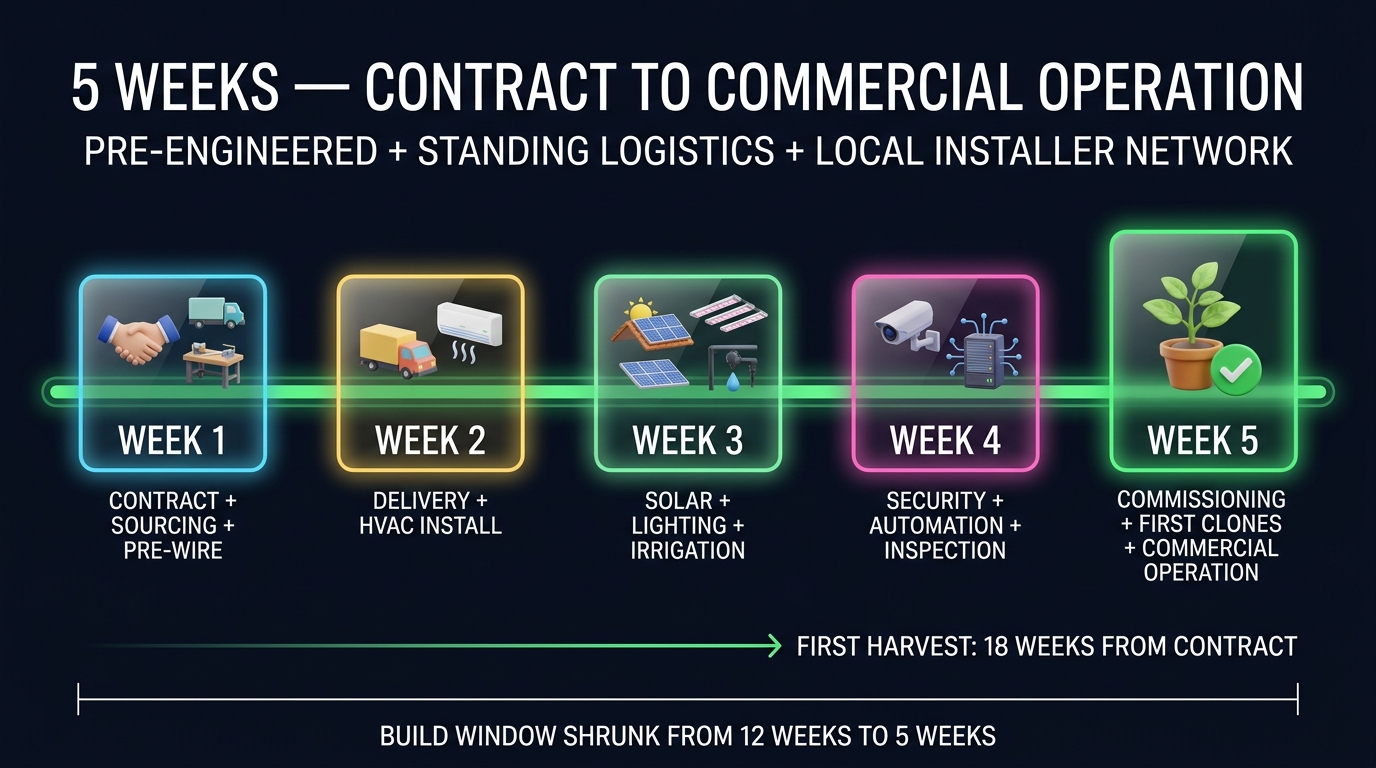

5-week build timeline — contract to commercial operation

Aggressive but realistic for a build that's been pre-engineered down to the last component, sourced from a standing Polish supply chain, and installed by Maltese contractors with whom Max Gozo already has working relationships. Most "3-month" cannabis facility builds in Malta are slow because the integrator is sourcing components on demand. Max Gozo's pre-existing logistics and installer relationships compress the timeline by an order of magnitude.

W1
Contract signature, deposit, Polish sourcing kick-off, electrical cabinet pre-wire, first weekly-truck consolidation
W2
Truck delivery to Malta, HVAC installer begins room-by-room install, electrical cabinet install starts
W3
Solar PV array on roof + battery commissioning, lighting hung, drip lines + irrigation manifold, fertigation controller wired in
W4
Carbon scrubbing, security cameras + access control, automation control plane configuration, sensor calibration, full dry-run, Maltese electrician inspection + certificate
W5
Commissioning, first clones in vegetative room, ARUC pre-op walkthrough, commercial operation begins, Max Gozo on-site for handover
WHY MAX GOZO

Four non-replicable assets

01

Standing Polish → Malta logistics chain

Weekly truck currently operational. Marginal shipping cost of the entire build is essentially zero.

02

Direct Maltese F-gas certified HVAC installer relationship

Commercial inverter cooling at favourable pricing including line sets and commissioning. Same-day swap stock for any future failures. No single point of failure in the cooling system.

03

Hands-on operational experience

Prior commercial indoor cultivation builds — LED at scale, propane CO₂ enrichment, sealed-room environmental control, Home Assistant local automation, electrical and security infrastructure end-to-end. See "Proof of Execution" below.

04

Polish supplier sourcing relationships

Premium European hardware at Polish wholesale pricing, delivered via the standing logistics chain. The structural foundation for the entire cost advantage.

PROOF OF EXECUTION

What I built before

October 2020. A vertical leafy-greens farm built from empty room to producing canopy in three weeks. Different crop, but the same technology stack proposed for Cultiva: Home Assistant local automation, propane CO₂ enrichment, Wago electrical infrastructure, PoE security cameras, suspended LED arrays, sealed-room environmental control. Below is the build sequence and live dashboard screenshots from that facility.

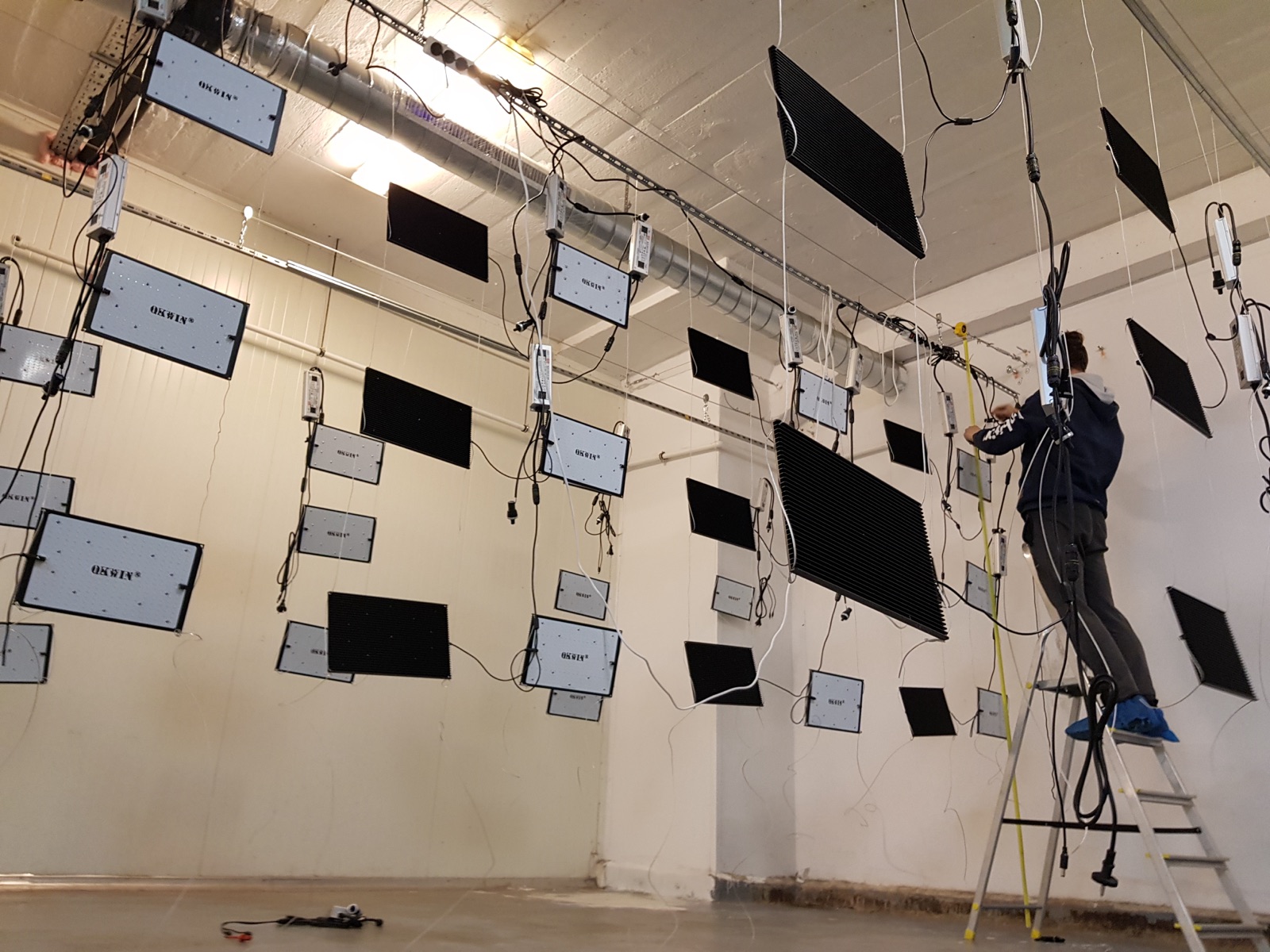

Day 1 — LED driver wall installation, person on ladder wiring fixtures
DAY 1 · DRIVER WALL

Day 3 — vertical NFT tower assembly in progress, components and tools
DAY 3 · TOWER ASSEMBLY

Day 3 evening — lighting commissioned, suspended LED panels illuminating empty towers
DAY 3 · LIGHTING ON

Propane CO₂ generator with blue LPG cylinder and inline gas controller
PROPANE CO₂ ENRICHMENT

Electrical infrastructure detail — Wago 221 connectors in junction box, PoE security camera, network switch
WAGO ELECTRICAL + PoE SECURITY

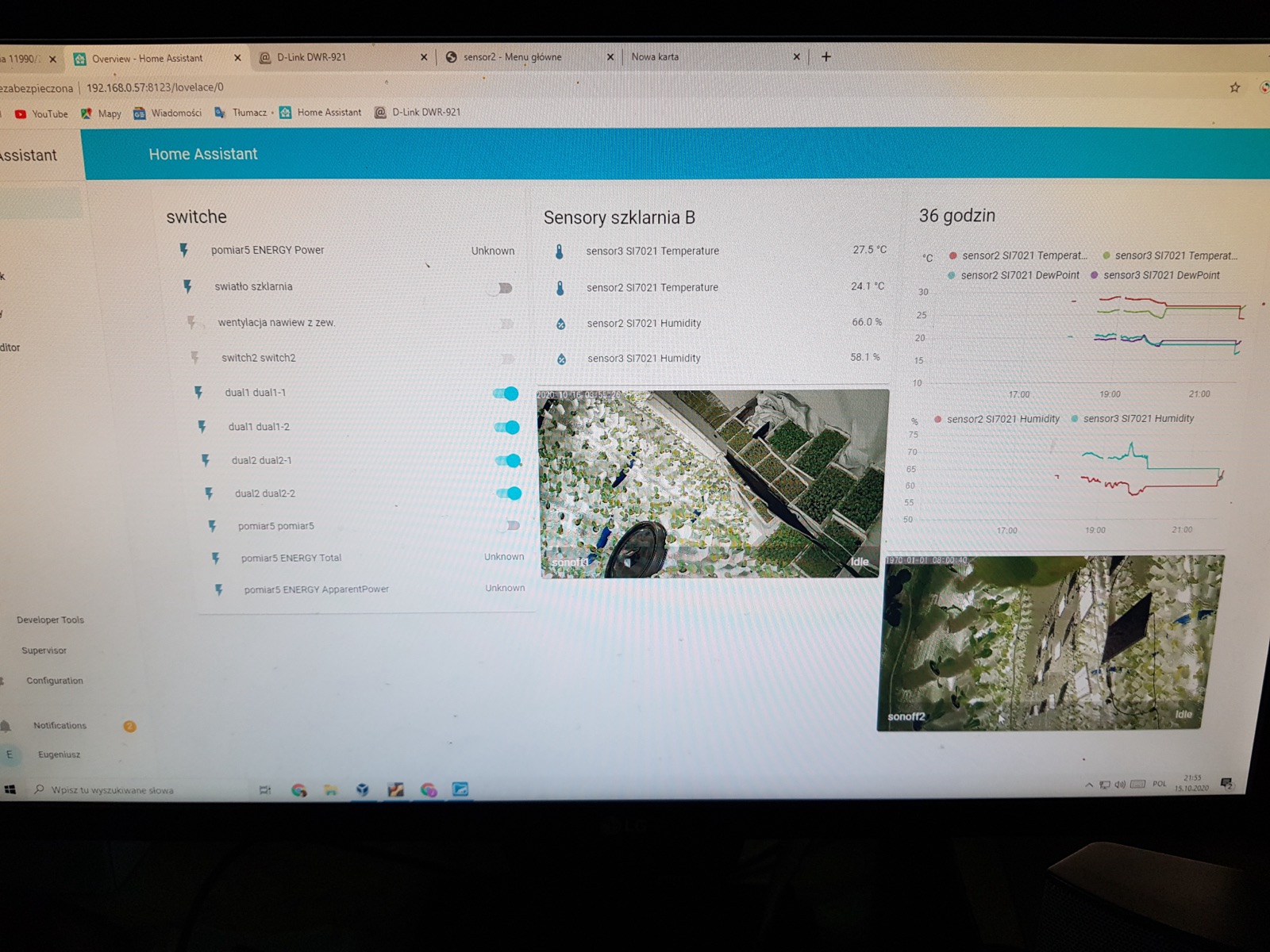

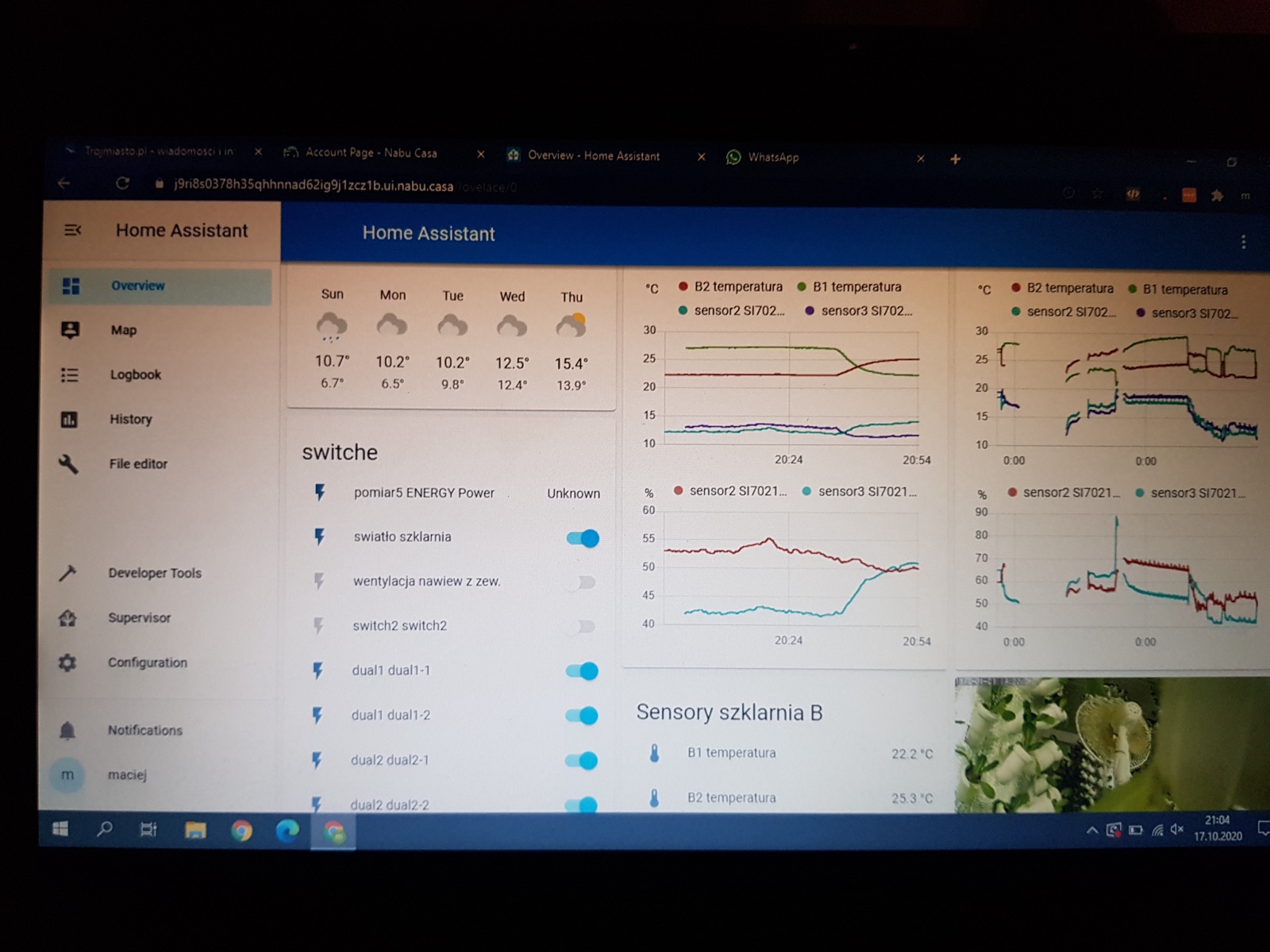

Home Assistant dashboard running live in production with sensor graphs and embedded camera feeds
HOME ASSISTANT LIVE

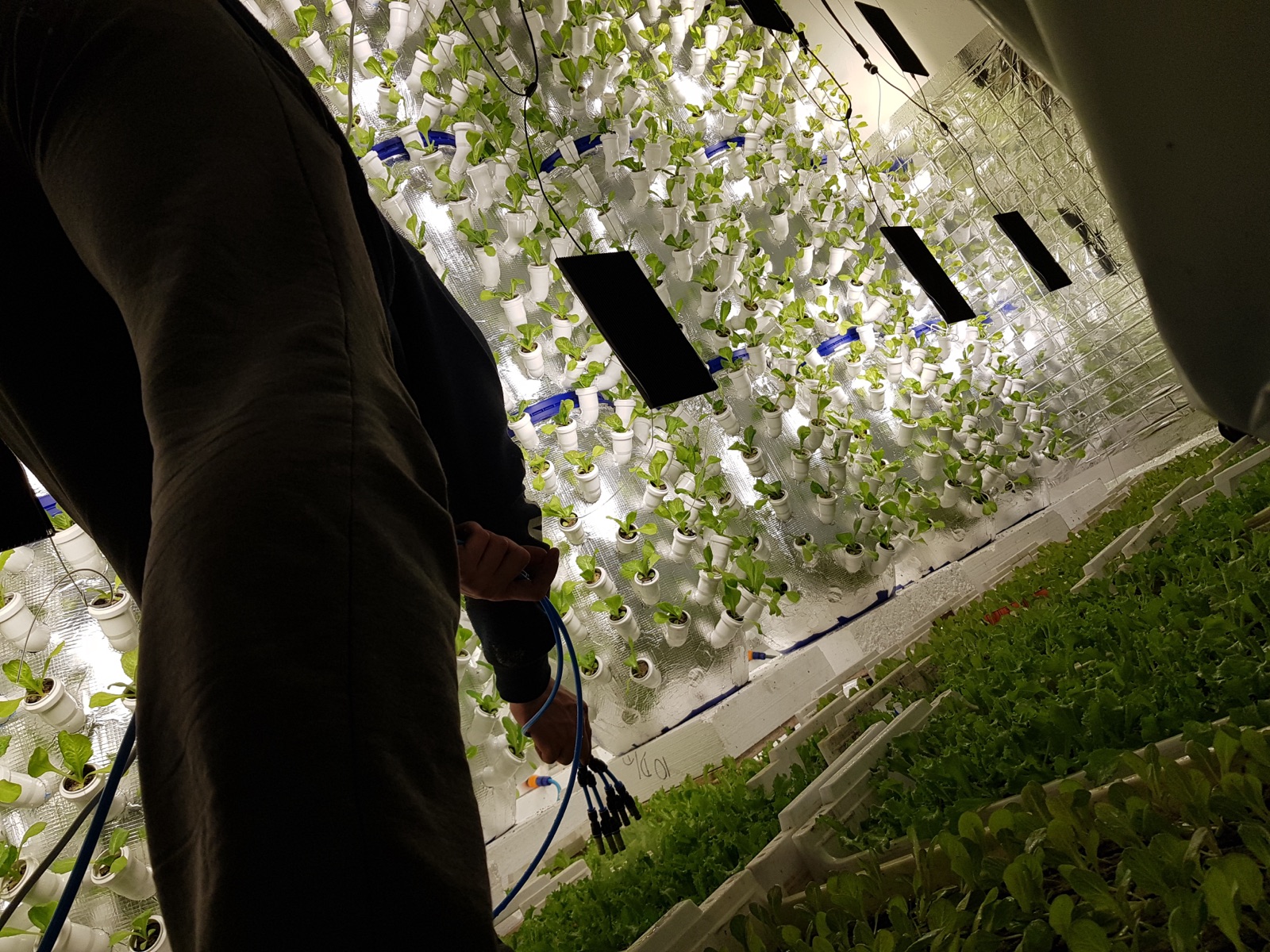

Day 6 — active commissioning, person inside grow room with cables, full tower array under LED light
DAY 6 · COMMISSIONING
Home Assistant dashboard with weather forecast, room temperature time series, humidity graphs
HA DASHBOARD & ALERTS

Day 21 — mature crop, full LED-lit grow room with mature lettuce towers and nursery seedling trays
DAY 21 · MATURE CANOPY

Cultiva uses horizontal benches with rockwool drain-to-waste for cannabis instead of vertical NFT towers for lettuce. The cultivation method is different. The integrator and the tooling are the same.

Ready to fund the build?

Three pre-investment due-diligence items, then the contract is signed and the build begins.

1. Maltese cannabis insurance quote on the engineered build
2. Cultiva lease terms confirmation
3. Three-phase electrical service capacity verification with the landlord and Enemalta
